Delong NTC Sensor Finishing Line
A September 2023 finishing-line proposal for Delong that combines boarding, 58-ohm resistor soldering, encapsulation, shell insertion, auto resistance and hipot testing, and quantified payback planning.

Project Snapshot
- Client Type
- NTC Sensor Manufacturer
- Timeline
- Proposal dated 2023-09-04
- Deliverables
- Boarding and resistor soldering section
- Encapsulation and turnover-fixture plan
- Shell insertion and dispensing segment
- Automated resistance and hipot testing stage
Background
Project scope
The Delong proposal from September 4, 2023 lays out an NTC finishing line built around 58-ohm resistor joining, board encapsulation, shell insertion, dispensing and automated resistance-plus-hipot testing.
Planning objective
The source does not stop at a process sketch. It also quantifies fixture counts, equipment counts, labor allocation and expected payback, making it a line-planning document as much as an equipment proposal.


Challenge
Multiple linked stages
The line has to coordinate cutting and boarding, resistor shaping and soldering, encapsulation, shell insertion, manual sleeve work and auto testing. That creates a typical finishing-line problem: several medium-speed stages that need consistent handoff and fixture return.
Fixture and operator balancing
The proposal sizes not only machines but also supporting assets such as turnover carts, encapsulation frames and potting fixtures. It also translates that into planned on-line labor and projected labor savings, which suggests the customer was comparing automation against a manual baseline.
Testing requirements
The test stage combines resistance and high-voltage verification, so it needs dedicated fixtures and stable loading logic rather than simple bench testing.


Approach
Line configuration

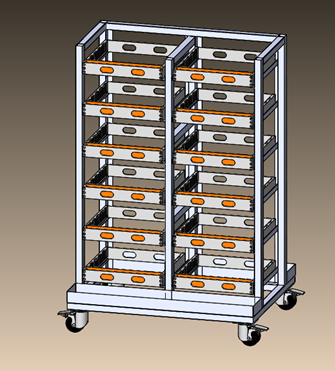

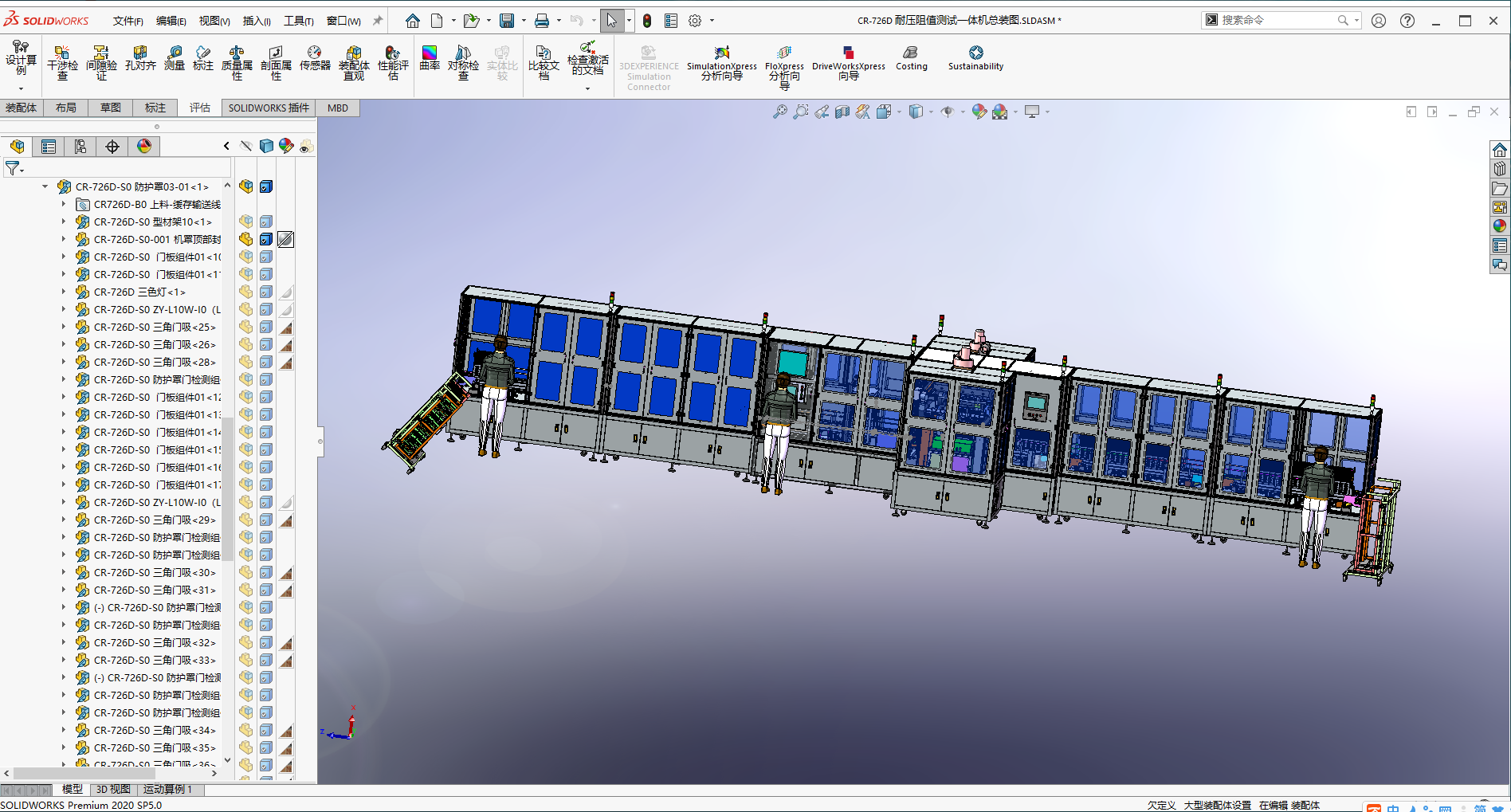

The proposal begins with automatic boarding and 58-ohm resistor soldering, then moves into encapsulation and shell-insertion stages. The middle process is supported by five turnover carts and sixty encapsulation frames, plus 150 potting fixtures for the later process.
Testing section
The testing segment is planned around one automatic resistance and hipot test machine. The source presents this as a core quality gate for the finishing line rather than a separate optional station.
Investment model
The proposal states an estimated tooling investment of about CNY 151,300 and equipment investment of about CNY 1.73 million, for an overall line investment of about CNY 1.8813 million. It also estimates that the automated line reduces on-line labor by 13 people and reaches payback in roughly 14 months.


Outcome
Proposed operating result
The Delong plan packages the NTC finishing route into one investment case covering process flow, support fixtures, testing and staffing. It gives the customer a clearer basis for deciding whether to move from manual work toward a more automated finishing line.
Business value
Because the proposal includes equipment counts, labor reduction and a payback estimate, it is positioned as an implementation-ready business case rather than only a technical concept.
